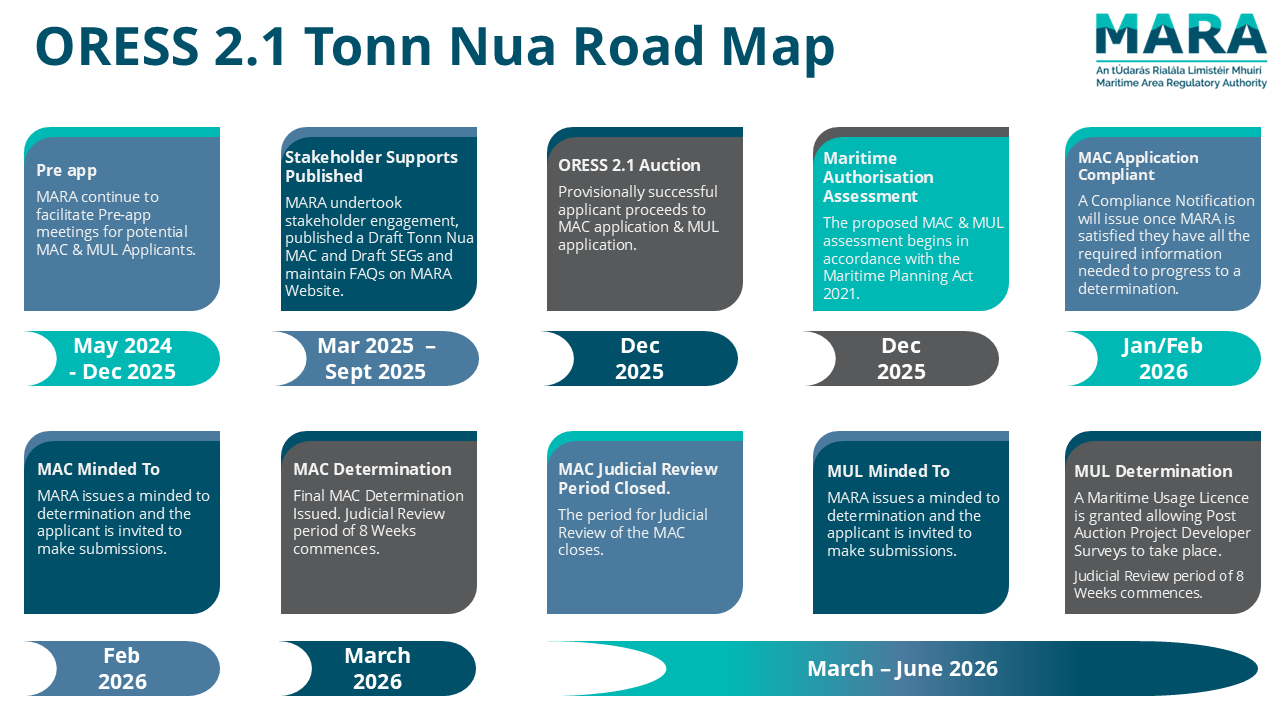

ORESS 2.1 – Tonn Nua
MARA has prepared the below draft documents in support of Tonn Nua
ORESS 2.1 – Tonn Nua FAQ
Listed below are some of the most frequently asked questions in relation to Maritime Authorisations for Tonn Nua. These have been split over three headings, General Questions, Financial Questions and Technical Questions. Click on the arrow beside the questions to expand and view additional details. MARA will continue to update this FAQ as queries arise, any further queries may be directed to mac@mara.gov.ie
General Questions
1. Do MARA envisage all ORESS applicants engaging in pre-application meetings with MARA during the preparation of their MAC applications?
MARA recommends that all ORESS bidders engage MARA for a MAC pre-application meeting. This meeting serves to provide clarifications on the MAC application process and requirements. Please note pre-assessment of application details will not be given within these meetings. Pre-application meetings are held on a non-statutory basis and without prejudice to any future MAC applications.
ORE pre-applications are prioritised by MARA Please complete Pre-Application Consultation Request Form and submit to mac@mara.gov.ie
2. Will details of pre-application meetings be published on the MARA website? This has been raised as a planning ground of challenge in relation to strategic infrastructure applications and assertion that the same is not in compliance with the Aarhus Convention.
No, MARA do not publish details of pre-applications held. Pre-application meetings are held on a non-mandatory basis and without prejudice. Brief notes of the meeting are recorded.
3. Will Eirgrid be responsible for making a MAC application for the transmission infrastructure?
Yes. All transmission and supporting infrastructure, including the cable route, substations and nearshore infrastructure which falls within the maritime area will require a MAC(s). The winner or ORESS 2.1 for Tonn Nua shall apply for the full Area A which is designated for the windfarm array.
4. How will the separate MACs between the ORESS 2.1 developer and Eirgrid interact in relation to overlaps (i.e. Eirgrid substation located within the ORESS 2.1 site)?
MACs are typically granted on a non-exclusive basis. It is envisaged that the Eirgrid and Developer MAC (Tonn Nua Area A) will overlap. This is subject to Terms and Conditions of ORESS 2.1 and connection agreements between Eirgrid and the Developer. Following the grant of these MACs, the holder may apply to MARA to amend the MAC or assign a part of the MAC.
5. Is the total duration of the MAC open for extension over and above the Phase 1 MAC durations to allow for equivalent operation phase?
There is nothing in the Maritime Area Planning Act 2021, as amended, precluding the Holder from applying for a new MAC or amendment to the MAC prior to the expiry of an existing MAC.
6. Will the MAC include condition(s) in relation to the Community Benefit Fund?
No. Requirements in relation to the Community Benefit Fund are included under the Terms and Conditions of the ORESS 2.1 Auction.
7. The requirement for onshore planning permission may not be known at the MAC application stage. How can this be addressed in Part 7 of the General Application for a MAC?
The applicant may cross reference any preparatory work undertaken by DCEE to establish the SC-DMAP. The applicant should also detail any preparatory work they plan to undertake pre-planning.
8. Will subsequent MAC applications from the ORESS 2.1 winner (e.g. for O&M base) be prioritised by MARA?
Yes. Applications for MACs and MULs are prioritised in accordance with MARA’s prioritisation system. Application for the ORE within a DMAP and related activity are highly prioritised by MARA.
9. What is the MAC Application process and Prioritisation system that applies from Final Auction through to Determination?
MARA has developed a dynamic and structured system for the prioritisation of all MAC and MUL applications to provide for effective decision making and to ensure that applications of national strategic importance are prioritised and delivered in a timely manner. When a complete application is received, and the fee has been paid, the application is ranked according to four specific prioritisation criteria; namely National and European priorities, Policy and Regulatory, Assessment Status and Application Age.
Applications for MACs and MULs are prioritised in accordance with MARA’s prioritisation system. Application for the ORE within a DMAP and related activity are highly prioritised by MARA.
Further details in relation to MARA’s application prioritisation system available here.
10. What does supporting entity guarantee cover?
The Supporting Entity Guarantee is to ensure payment of levy up to commercial operation / build completion. “Commercial Operation Date” means the date that the Project achieves commercial operation as defined in the MAC.
11. What Levy Fee Framework will apply to Phase 2.1?
The MAC levy shall be in accordance with Levy Framework as published on the MARA website: here. This levy framework is developed in accordance with Section 92 of the MAP act and requires the consent of the Minister for Public Expenditure, Infrastructure, Public Service Reform and Digitalisation. MARA is obliged under the MAP act to keep this framework under review.
12. What mechanism will be used to charge Eirgrid in terms of MAC levy?
The MAC levy shall be in accordance with Levy Framework as published on the MARA website: Here
13. What are the anticipated processing times for MAC applications?
Applications for MACs and MULs are prioritised in accordance with MARA’s prioritisation system. Application for the ORE within a DMAP and related activity are highly prioritised by MARA.
Timeframes for determination will be dependent of the quality of applications, and response by applicants to any notices issued.
14. Should the MAC application be submitted for the entire Tonn Nua area?
According to Section 7.3.9 of the Terms and Conditions for the ORESS 2.1 Auction, the provisional winner of the ORESS Tonn Nua Auction must make a MAC application in respect only of the Project Development Area specified in the Designated Maritime Area Plan (and not a greater or lesser area).
15. Can a developer make an application for MUL for site investigations associated with Area A before a MAC determination is made?
There is nothing in the Maritime Area Planning Act 2021, as amended, precluding developers from applying for MUL at the same time as the MAC application. MARA will have regard to government policy when considering such an application (Refer to Circular MP01/2024).
Applications for MULs will be prioritised in accordance with MARA’s prioritisation system. Application for the MAC and MUL made by the provisional winner of the ORESS 2.1 auction will be highly prioritised.
16. Will MARA be facilitating pre-application meetings on MUL prior to the ORESS 2.1 auction?
Yes. Pre-application meetings can be arranged by completing Pre- Application Request Form and submit to licence@mara.gov.ie.
ORE pre-applications are prioritised by MARA.
17. What are the anticipated processing times for MUL applications?
Applications for MACs and MULs are prioritised in accordance with MARA’s prioritisation system. Application for the ORE within a DMAP and related activity are highly prioritised by MARA.
Timeframes for MUL determination will be dependent on the quality of applications, response by applicants to any notices issued and any the nature and number of submissions received in response to public consultation.
18. What is the process for submitting a MAC application to MARA?
Upon request, MARA will set up a file-sharing cloud platform to enable the submission of MAC applications. MARA can also accept submissions via email up to 20MB.
Note in order for an application to be considered complete, the application fee must be paid in full. Details of how to pay the application fee are available at Section 2.6 of Guidance Note for Applicants applying for a Maritime Area Consent (MAC)
19. Will a MAC compliance check be done at the ORESS 2.1 qualification stage?
No. Please refer to 7.3.9 and Section 10 of the Terms and Conditions for ORESS 2.1 Auction. Once a preliminary auction winner is announced, they shall apply to MARA for a MAC. MARA will independently assess and determine the MAC application.
20. Is the MAC applicant required to prepare their own application map and GIS files for Tonn Nua – Maritime Area A?
No. The applicant is not required to prepare a MAC map or GIS files for the Tonn Nua Area A. MARA shall prepare the MAC map based on the SC-DMAP area published by DCEE. The application is expected to cover the entire area of the Area A.
21. General Application (Form MAC1) – Part 2 Nature and Scope of the Project:
What level of detail and what project parameters are required to be included under this section?
The Scope and Nature of the Maritime Usage to be undertaken must be fully described and should detail any works or activities in the Maritime Area required or necessary, as relevant, to undertake, construct, complete, commission, operate, maintain, decommission and rehabilitate the proposed usage.
22. Are Tax Clearance Certificate and relevant TCC Number required for the applicant only?
As set out in the Guidance Note for Applicants applying for a Maritime Area Consent (MAC, Part 5 “Tax Compliance – The applicant must be tax compliant, both at the time the application is made and at the time that the MAC application concerned is determined by MARA.” Tax Registration Number and Tax Clearance Access Number are required to be submitted for the applicant.
23. General Application (Form MAC1) – Part 7: Preparatory Work:
What level of detail is required to be included under this section, given the application area has been designated through a DMAP?
The applicant may cross reference any preparatory work undertaken by DCEE to establish the SC-DMAP. The applicant should also detail any preparatory work they plan to undertake pre-planning.
24. General Application (Form MAC1) – Part 8: Stakeholder Engagement:
What level of detail is required to be included under this section, given the application area has been designated through a DMAP?
The applicant may cross reference any stakeholder engagement undertaken by DCEE to establish the SC-DMAP. The applicant should also detail any stakeholder engagement they plan to undertake pre-planning.
25. Are the general MAC application guidance and applications forms proposed to be revised ?
The revised General Guidance notes for Applicants, which includes Technical and Financial Guidance along with Application forms were published on 20 August 2025. Please see Applying for a Maritime Area Consent – MARA – The Maritime Regulator.
The revisions provide additional clarity and transparency in relation the MAC process and application requirements. There was no material change to the benchmark requirements for MAC application assessment.
Please use the current guidance an application forms on our website.
26. In addition to the application forms, can an applicant submit supplementary information to support the application?
If an applicant wishes to submit additional supporting information along with their application form, they may do so by clearly appending the additional document and cross referencing these within the general application form. All supporting information submitted should be relevant to the MAC application and the criteria to which MARA may have regard to, as set out within Schedule 5 of the Maritime Area Planning Act 2021, as amended.
27. Fit and Proper Person for Non Individual (Form FPP1 – Section 2) :
Are letters of reference a requirement of the MAC?
Letters of reference may be included within the application, where deemed appropriate, to evidence that the applicant is fit and proper.
28. What are the anticipated timeframes for application and determination of a MAC by Eirgrid for the transmission infrastructure?
EirGrid have made a Maritime Usage Licence application for marine survey works proposed to commence in 2025 to enable site and cable route selection. EirGrid have indicated that they intend to make a MAC application to MARA following site and cable route selection. EirGrid currently project that they shall make a MAC application to MARA in early 2027 following pre-application engagement over 2025 and 2026 in line with project evolution. Please refer to Offshore Energy Future Projects – EirGrid in relation to EirGrid’s plans for Government’s South Coast DMAP. Application for the ORE within a DMAP and related activity are highly prioritised by MARA. Further details in relation to MARA’s application prioritisation system available here.
29. In the case that a Judicial Review is brought against a positive MAC decision, what are the communication obligations on MARA to keep DCEE informed in that instance?
MARA will follow the formal legal process. MARA will inform DCEE and the applicant of any judicial review taken and provide updates with regard to timeframes. Once any Judicial Review is concluded, MARA will engage with DCEE and the applicant on the outcome.
30. What are the acceptable forms of financial indemnity for the Rehabilitation Bond?
A rehabilitation bond may include an irrevocable draw down letters of credit / bank guarantees / performance bonds, and subject to Ministerial approval an upfront cash deposit account or a cash accrual account. Parent Company Guarantees are typically not acceptable as a primary source of security but may be used by agreement with MARA in exceptional circumstances as a short-term form of security
31. Are temporary work areas permitted outside the MAC area?
All works, including temporary works, activities and structures must be located within the boundary of the MAC area. This includes the full span of turbine blades (i.e. overhang) and all temporary works, including anchors, buoys etc.
According to Section 7.3.9 of the Terms and Conditions for the ORESS 2.1 Auction, the provisional winner of the ORESS Tonn Nua Auction must make a MAC application in respect only of the Project Development Area specified in the Designated Maritime Area Plan (and not a greater or lesser area).
32. If granted a MAC what are the Holder’s rights to surrender/ withdraw the MAC?
There is legislative provision under Section 88 and Section 89 of the MAP Act where the holder of a MAC may make an application in the specified form, accompanied by the specified fee, to the MARA for the surrender of a MAC.

Financial Questions
1. How will MARA assess the ongoing financial criteria if at any stage prior to FC one of the criteria is temporarily not met by one of the applicant parties or its supporting entity?
Please note MARA adopts a comply or explain approach under the Financial Capability Assessment. Further details are provided under Section 6 – Comply or Explain in Appendix C of Guidance Note for Applicants applying for a Maritime Area Consent MAC.
Refer to Section 9 – Ongoing Compliance in Appendix C of Guidance Note for Applicants applying for a Maritime Area Consent MAC.
2. In relation to supporting entity guarantees, can a bidder use a Guarantor within their group to meet the financial criteria ?
In order to prove financial capability, a Relevant Person may rely on the resources of another entity(s) or undertaking(s), which may be a parent or a non-parent company (“Supporting Entity”). Where this is the case, the financial capability assessment will be carried out on the Supporting Entity(s) and not the Relevant Person.
Where a Supporting Entity(s) is relied on to meet financial test thresholds, a Supporting Entity Guarantee (“SEG”) must be signed. The SEG does not form part of the financial capability assessment and the purpose of SEG is to ensure payment of levy up to commercial operation / build completion.
3. Can a Relevant Person provide a third-party letter of credit (from a lender) for the purpose of Financial Capability testing?
MARA considers all types of credible funding arrangements. Please refer to Section 7 – Funding Arrangements in Appendix C of Guidance Note for Applicants applying for a Maritime Area Consent MAC. A Relevant Person may obtain or provide a letter of credit from a financial institution (e.g., a bank) guaranteeing the payment of costs on time where the Relevant Person is unable to cover its Project Costs.
All related letter of credit documentation should be submitted with the MAC application. In cases where a MAC is granted in advance of funding arrangements being finalised, documented evidence of secured funding must be furnished to MARA.
4. What is the definition of Project Costs?
The definition of Project Costs is any cost/financial commitment including capital, financing and other but excluding contingent liabilities in respect of a MAC project. Project costs includes all costs up to and post Build Completion or COD, including but not limited to design, planning and construction. Refer to the Financial Capability Assessment Guidance for further details.
5. What is the definition Outstanding Project Costs?
The definition of Outstanding Projects is depending on the stage of the project, Outstanding Project Cost is calculated as follows: – Up to FC: Any cost/financial commitment including capital, financing and other but excluding contingent liabilities, associated with a proposed project or a granted MAC, which has not yet been incurred/expensed up to the estimated date of FC. – Post FC: Any cost/financial commitment including capital, financing and other but excluding contingent liabilities, associated with a proposed project or a granted MAC, which has not yet been incurred/expensed up to the estimated date of COD. Refer to the Financial Capability Assessment Guidance for further details.
6. Where a MAC application is refused or a granted MAC is quashed under judicial review, how will the MARA inform the DCEE that the bond can be returned to the developer?
Please refer to Terms and Conditions for ORESS 2.1 Auction
7. Will the MAC Holder be required to reserve cash on an annual basis from 5 years prior to the end date of the maritime area to fund rehabilitation costs?
No, the Tonn Nua MAC Holder will not be required to reserve cash on an annual basis. However, the Holder will be required to post a Rehabilitation Bond not later than 60 days prior to the commencement of any works on foot of Development Permission, as set out in Condition 16 of the Draft Tonn Nua MAC.
8. Can Rehabilitation costs be estimated?
Responsibility for agreeing a rehabilitation plan in relation to MACs (Section 75(1)) rest with the planning authority. However, project costs should include estimated project costs for rehabilitation in order to ensure the applicant is financially capable of delivering and rehabilitating the project.
9. What rehabilitation costs should be included in the application form for the Wind Turbine Generator area and Eirgrid transmission asset area ?
The applicant for the windfarm should include rehabilitation cost for their infrastructure and Eirgrid should provide rehabilitation costs for transmission infrastructure
10. Is there a process in place that allows for a company name change or entity change during the MAC application process?
No, there is no such process in place at present.
11. Is there a process that allows for an entity change during the MAC application process?
It is preferable that changes to applicant entities are not made during the application process, particularly with regard to the relevant person(s) for the purpose of financial or technical capability assessment. Such changes will/may require full financial and/or technical capability reassessment and result in delayed timeframes for the MAC determination.
12. Is there a process for a successful bidder to assign a MAC?
Yes. Section 85 of the MAP Act specifies an assignment process
13. Is there a sample Supporting Entity Guarantee?
A sample is provided here. Based on information submitted in the relevant application form, MARA will draft a SEG, which must be signed by the Supporting Entity. Upon receipt of the original signed SEG, it will be reviewed and verified by MARA and an executed copy of the SEG will be sent to the Relevant Person. The original executed document will be retained by MARA. Note: the above template is subject to change
14. What does the Supporting Entity levy cover for ORESS 2.1 ?
The Supporting Entity Guarantee is to ensure payment of levy up to commercial operation / build completion i.e. the Development Stage Levy. “Commercial Operation Date” means the date that the Project achieves commercial operation as defined in the MAC.
15. When is the Levy payable and at what rate?
The Holder shall pay to the Grantor the specified levy within one month from the commencement date of the Maritime Area Consent (MAC) and on every succeeding anniversary for the term of the consent. The Levy is calculated according to The Levy Framework as published on MARA’s website. All levies are indexed to the Harmonised Index of Consumer Prices (HICP), applied on an annual basis.
16. What percentage of the Levy does the SEG cover ?
Supporting Entity is to cover the full levy (i.e. 100%). Where multiple Supporting Entities are used, the SEG will be for the percentage of the project to which they give support.
17. Are Project Costs for other MACs held assessed at the percentage of ownership of the Relevant Person on a joint application?
The Relevant Person’s share of all Outstanding Project Costs in each MAC project or application, will be factored into the financial resources test of the Relevant Person.
18. What is the definition of total outstanding project costs to Financial Close?
Total Outstanding Project Costs Up to Financial Close is defined as: Any cost/financial commitment including capital, financing and other but excluding contingent liabilities, associated with a proposed project or a granted MAC, which has not yet been incurred/expensed up to the estimated date of Financial Close.
19. Can the entity providing the SEG be different to the entity relied upon for the purpose of the financial capability assessment?
The supporting entity relied upon for the purpose of the financial capability assessment is required to provide the supporting entity guarantee.
20. Can other forms of guarantee such as letter of credit be utilised or is the SEG the only way of guaranteeing the payment of MAC annual levies?
A supporting entity guarantee is required.
21. Should the SEG template be completed and submitted with the MAC application?
Applicants are not required to submitted the SEG template as part of their MAC application.
Based on information submitted in Form B of the Financial Capability Assessment Application Forms, MARA will draft a Supporting Entity Guarantee (SEG). Further information in relation to the SEG process is provided within Appendix C of MARA’s Guidance Note for Applicants applying for a Maritime Area Consent (MAC)
22. Will MARA be publishing an updated draft Supporting Entity Guarantee for multiple guarantors?
Any supporting entity guarantee for multiple guarantors will follow a similar format to the Supporting Entity Guarantee published on 5th September save for adjustments necessary to reflect multiple guarantors.

Technical Questions
1. Does the “Comply or explain” policy also relate to the technical capability application form?
Yes. Where a Relevant Person is unable to meet any of the technical capability requirements, this will not automatically result in the Relevant Person failing the technical capability assessment. However, the onus is on the Relevant Person to provide a sufficient explanation for each requirement not met, along with supporting evidence of extenuating circumstances or mitigating actions.
The Comply or Explain policy relates to all MAC applications including ORE applicants for the technical capability assessment and MARA reserves the right to deem applicants fit and proper based on the information submitted. The “Comply or explain” approach gives MARA the flexibility to make realistic decisions about applicants current and committed resources which in turn is likely to lead to better outcomes in relation to regulation of the maritime area while also encouraging openness in the application process.
2. Section 5 of the Maritime Area Consent MAC Technical Capability Assessment for Schedule 10 Projects Form TCA1 requires applicant to outline delivery timelines that demonstrate how first generation will be achieved in advance of the 2030 target will be achieved. Can timelines be set out to the 2034 longstop?
Yes, delivery timelines must demonstrate how first generation will be achieved in advance of the 2034 long stop.
Maritime Area Consent MAC Technical Capability Assessment for Schedule 10 Projects Form TCA1
3. Can examples of previous experience include projects undertaken as Joint Ventures / Partnerships?
Yes, provided the elements of the project used to demonstrate the criteria were undertaken by the relevant person.
4. Section 4.3 of the Maritime Area Consent MAC Technical Capability Assessment for Schedule 10 Projects Form TCA1 – Description of relevant person’s Experience with Projects of a Similar Scale and Nature
How many pages per stage (development/construction/operation may the applicant use to demonstrate project capability?
It is not expected that applicants would use 6 projects to demonstrate 12 months continuous experience for any given stage. The maximum expected input for the final cell in the table in Section 4.3 should be 3 pages for each stage. i.e. 9 pages in total.
Maritime Area Consent MAC Technical Capability Assessment for Schedule 10 Projects Form TCA1
5. Section 5 of the Maritime Area Consent MAC Technical Capability Assessment for Schedule 10 Projects Form TCA1 – Project Delivery Timelines
What level of information is required to be included in relation to the ‘Submission of Rehabilitation Schedule (approved through Development Permission process)’.
The rehabilitation schedule should be that as approved by the planning authority as part of development permission.
Maritime Area Consent MAC Technical Capability Assessment for Schedule 10 Projects Form TCA1
6. Section 4.3 of the Maritime Area Consent MAC Technical Capability Assessment for Schedule 10 Projects Form TCA1 – Description of relevant person’s Experience with Projects of a Similar Scale and Nature
Is there a minimum amount of time required for the ‘Senior Member of the Team’ (having at least 10 years’ experience) to be available for the project?
The guidance note does not stipulate what percentage of each senior team member’s availability must be dedicated to the project overall. However, if an applicant is depending upon a single senior team member to demonstrate the 10 years’ experience required for a particular criteria, it is expected that the relevant team member would be available to the project on a full-time basis for the stage to which their experience relates. For example, a project team member who has been put forward to demonstrate 10 years prior offshore wind development and construction experience should be 100% available to the project during the development and construction stages. It is acknowledged that experienced team members will work on other projects/roles within an organisation from time to time. Please note that being 100% available to work on the project does not mean that the senior team member only works 100% of their time on that project.
Maritime Area Consent MAC Technical Capability Assessment for Schedule 10 Projects Form TCA1
7. There was a change in relation to Phase 1 (operations phase) and current guidance (operations and maintenance)- please confirm this is a change in wording only and that the operational and maintenance test may be met by ownership of an offshore wind project greater than the defined capacity that has passed the milestone of first generation in excess of 12 months?
Yes, demonstration of satisfactory operation and maintenance experience may be met by ownership of an offshore wind project greater than the defined capacity that has passed the milestone of first generation in excess of 12 months.
8. Please clarify if the Planning and Development experience requires the applicant to have obtained a planning consent for an offshore project within the preceding 10 years?
A Senior Member of the Team shall be able to demonstrate at least 10 years of experience of the Planning system delivering projects of a similar scale and nature (including terrestrial projects).
9. What is the definition of “similar scale and nature” as described in the Project Delivery Team (PDT) Experience?
As per Appendix B Technical Capability Assessment Guidance, Guidance note for Applicants applying for a Maritime Area Consent (MAC) (applying to Schedule 10 Projects), the Project Delivery Team Experience of senior members of the team for Offshore Renewable Energy Projects shall be able to demonstrate at least 10 years of experience, for each of the following:-
(a) at the development and construction stages of an offshore wind farm up to the point at which first generation of all or part of the offshore wind farm is achieved;
(b) of renewable energy development experience where development experience means the development and construction stages of a renewable energy development up to the point at which first generation of all or part of the renewable energy project is achieved; and
(c) of the Irish Planning system delivering projects of a similar scale and nature (including terrestrial projects).
Overall, this approach aims to foster a wider range of participation and expertise in the emerging local offshore wind sector.
10. Can “aggregate” experience be relied upon to demonstrate Project Delivery Team experience?
Yes, the more than one person’s experience can be used to demonstrate a total (aggregate) 10 years experience for the Project Delivery Team. For example, where two of the Project Delivery Team have five years of the appropriate service, these can be aggregated to equal the ten years necessary.
11. Are applicants required to include a Navigational Risk Assessment with their Tonn Nua MAC application as outlined in Section 5.7 Preparatory Works of the recently revised Guidance Note for Applicants applying for a Maritime Area Consent (MAC)?
The guidance note covers all types of MAC applications, and the list of preparatory works which the applicant may have undertaken is not prescriptive. Applicants are only required to list preparatory works which are relevant to their application. MARA do not expect applicants to have completed a Navigational Risk Assessment at Tonn Nua MAC application stage. Navigational issues will be considered by An Coimisiún Pleanála as part of the Tonn Nua development consent process.
12. What is meant by “Derived data” in relation under Condition 1.1(g)(i) to (iii) of the Draft Tonn Nua MAC?
Derived data is any data that is directly calculated or processed from the data types enumerated under the definition for Data at 1.1(g)(i) to (iii) in the Draft Tonn Nua MAC. It does not include design or process information.
13. Will data furnished to MARA in accordance with Condition 10 of the Draft Tonn Nua MAC be released by MARA or its agents?
Data will be treated as confidential by MARA and any entity holding data on its behalf up until the point a planning application is submitted to An Coimisiún Pleanála, as set out in condition 10.8 of the Draft Tonn Nua MAC. However, it should be noted that this confidentiality is subject to MARAs obligations under law as set out at section 10.10 of the Draft Tonn Nua MAC.
14. What if a MAC holder is unable to meet the requirement to provide data schedule within the 8-week timeframe in accordance with Condition 10 of the Draft Tonn Nua MAC?
The MAC holder should engage with MARA at the earliest opportunity if it is anticipated that the timeframe cannot be met. MARA acknowledge that specific circumstances may arise where it is not beneficial to transfer data to MARA or an entity holding data on MARA’s behalf and this may be agreed by MARA at its discretion.
